Report No. |
5961 |
Type of audit |
Rig Intake |
Auditee/Customer |
Odfjell |
Date |
2023/11/10 |
Findings |
20 |
Status |
In process |
Closed
Deadline was:
IOGP 476 has requirements for level one for roustabouts, crane operators and deck crew. Level 2 requirements for Roughneck, subsea eng. and derrickman. Odfjell has a non-conformance from IOGP 476 related to level 1 for crane operator, and deck crew and level 2 for derrickman and roughneck. Although IOGP 476 is a guideline, PSA communicated during previous audits of Wellesley and DNO that this is now a requirement.
Odfjell to send information how to comply.
Odfjell have evaluated the requirements and concluded: Deck crew and crane operators will take level 1. This is an digital course. dec crew that have drilling education will get a deviation according to IOGP (qualifying examples of work related experience that may lead to considereing dispensation includes – regional vocational training schemes, dvs yrkesrettet utdanning) Roughneck and Derrickman are covered by the education VK2 well technique or equivalent drilling course/education.
Stig Seland
In Process
Deadline was:
A-1: Competence review meeting to be scheduled 1 month before spud.
20.02.2024 ÅKP: Spud is posponed to september.
Åse Kristin Pettersen
Closed
Deadline was:
A-2: A copy of following internal deviations is requested: 215012 222822 228564 228566 228568 228542
08.12.2023 ÅKP. One requested synergi numer was wrong (228542) It should be 228842. Received
Åse Kristin Pettersen
Closed
Deadline was:
A-3: Review agenda for Bi-weekly HSE meeting.
20.02.2024 ÅKP: Ageda will remain, however a more efficient meeting is the new way (30 min). Tuesdays at 10:30
Åse Kristin Pettersen
Closed
Deadline was:
A-4: List of open synergi cases
Forward list of open synergi cases for DSY
Open synergi cases are uploaded to dataroom. 27 cases registered and 19 of these were registered as medium risk.
Åse Kristin Pettersen
In Process
Deadline was:
A-5: Odfjell to forward plan for organisational and operational barriers to be visualised
Åse Kristin Pettersen
Closed
Deadline was:
A-6: New class status report to be sent when conditions are closed.
ÅKP: Class status report15.01.2024
Åse Kristin Pettersen
Closed
Deadline was:
A-7: External audit plan (Odfjell’s verification plan towards suppliers) to be forwarded.
Received: 4services, Afrishore and Puglisevich was on the plan in 2023
Åse Kristin Pettersen
Closed
Deadline was:
A-8: Send information regarding level 1 and 2 course. Odfjell to send justification for requirements related to IOGP476.
Level 1 is a digital course. The Level 1 course has 7 modules which cover the following topics: -Overview of Oil and Gas -Life Cycle of a Well -Drilling Rigs -Well Control During Drilling Operations -Well Intervention and Workover -Pressure Control During Well Intervention Conclusion. At the end of each module there is a knowledge check which candidate must successfully complete before moving on to the final exam. If a pass mark of 70% or more is achieved in the final exam candidates will be able to access their online certificate. Deck, Ass. crane driver will take level 1 course. deck personnel that have drilling course/drilling technical education gets dispensation. Roughneck, derrick man is coverd by the fagutdanning VKS2 brønn teknikk or similar accoring to Offshore Norge guideline 024.
Åse Kristin Pettersen
Closed
Deadline was:
A-9: DROPS survey from Axess to be sent with status on findings. Both report and Synergi to be sent.
13.11.2023 Received
Åse Kristin Pettersen
In Process
Deadline was:
A-10: Experience with screen washer from DSN to be communicated.
Mail from Odfjell 08.12.2023: VI har pr i dag en screenwasher men vi undersøker hvilke modeler som er mest egnet et DSY pga brukervennlighet og best egnet plassering i shaker) 20.02.2024 ÅKP: Odfjell har ikke landet på noen avgjørelse om scree washer enda. Utsetter frist til august.
Åse Kristin Pettersen
Closed
Deadline was:
A-11: Forward HAVS procedure when ready.
Received: 08.12.2023
Åse Kristin Pettersen
Closed
Deadline was:
A-12: Update measurement program with Biobar 32 usage
Send updated measurement program
ÅKP 07.02.2024 Received. version 7
Sanne Drivflaadt Risbakk
Closed
Deadline was:
A-13: Forward overview document over all equipment and energy consumption
Received by email 08.12.23
Sanne Drivflaadt Risbakk
Closed
Deadline was:
A-14: Forward all energy saving initiatives planned for DSY
Received by email 08.12.23
Sanne Drivflaadt Risbakk
Closed
Deadline was:
A-15: Prepare L3 procedure for handling of drones within 500m zone. What do one do if the drone lands on the rig?
Received 08.03.2023. Not a procedure but a presentation of what to do… (Handlingsmønster)
Åse Kristin Pettersen
In Process
Deadline was:
A-16: Follow-up of maintenance numbers
Stig Seland
Closed
Deadline was:
A-17: Send updated helideck certificate
Received 19.02.2024
Stig Seland
In Process
Deadline was:
A-18: Odfjell to inform RIT on timing for startup of maintenance on diesel generators in due time.
Stig Seland
Open, Deadline was:
A-19: Findings from the Cranes and lifting verification to be followed up.
Stig Seland
ODFJELL-DSY-RIG-INTAKE-Review-Meeting_rev01_signed.pdf

PGNIG-TOMC-D-RA-0012-Odfjell-Rig-Intake-Review-Meeting-Report-26th-of-September.pdf
215012.pdf

222822.pdf

228564.pdf
228566.pdf

228568.pdf
234592-NC-1-IOGP-476.pdf
234594.pdf

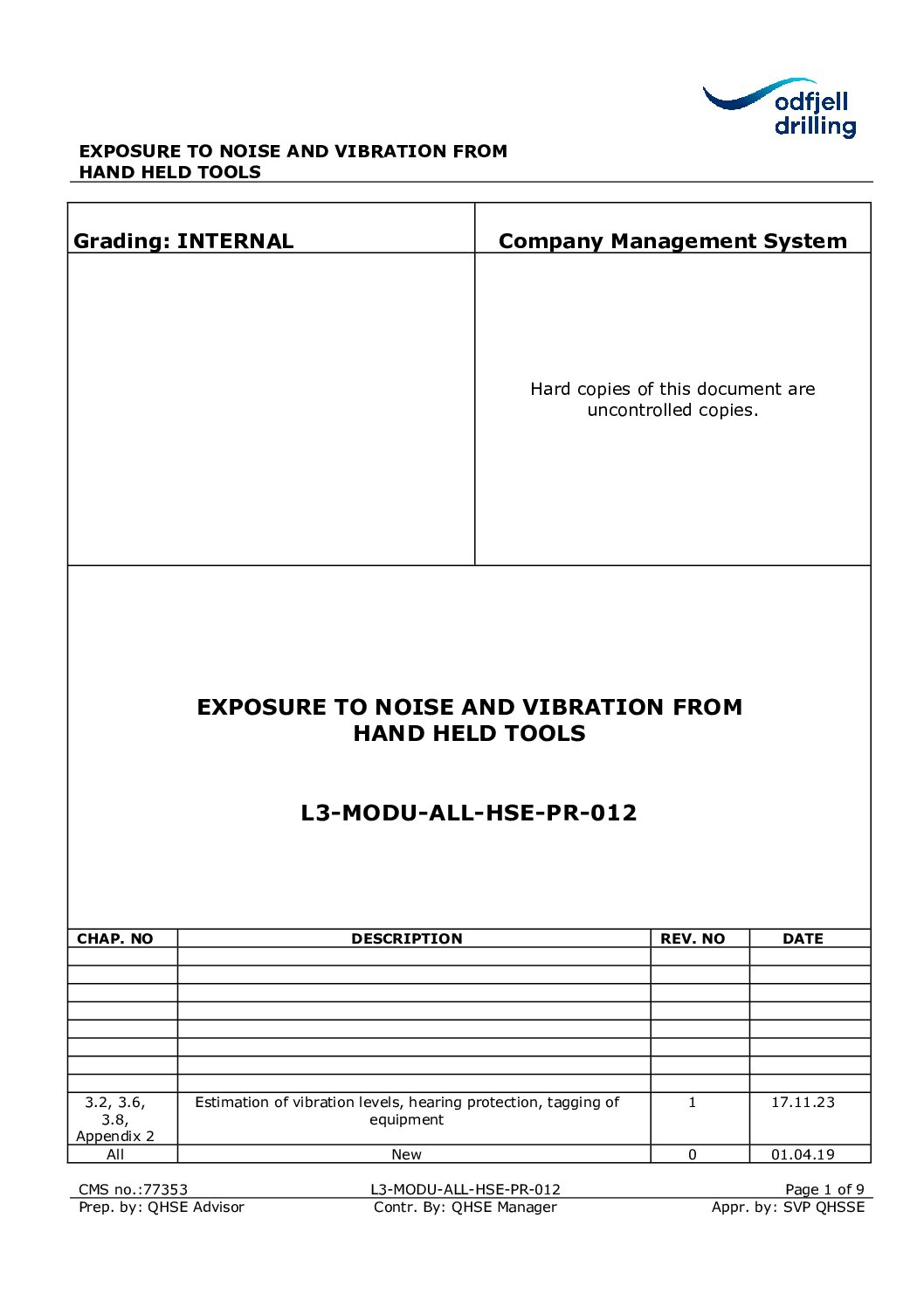

EXPOSURE-TO-NOISE-AND-VIBRATION-FROM-HAND-HELD-TOOLS.pdf
258034-16-278-01-Picture-log-Findings-DROPS-inspection.pdf
258034-16-272-01-Field-Service-Report.pdf
Deepsea-Yantai-Certificate-2023.pdf
